Barkly East 298: Delivering Civil Infrastructure Under Challenging Site Conditions

Barkly East 298: Delivering Civil Infrastructure Under Challenging Site Conditions

Kantey & Templer provided the design and construction supervision of internal civil engineering services supporting a new residential development in Barkly East, Eastern Cape.



Barkly East civil infrastructure development site in the Eastern Cape

Infrastructure projects rarely unfold exactly as anticipated.

At Barkly East Township in the Eastern Cape, Kantey & Templer was appointed to provide the design and construction supervision of internal civil engineering services for a residential development intended to help address the need for housing infrastructure in the area.

The works included water and sewer reticulation, internal roads and stormwater infrastructure as part of the original scope, servicing 303 residential stands.

Aerial view of Barkly East Township and surrounding residential development

What began as a relatively defined civil infrastructure project developed into a technically challenging construction programme requiring the project team to respond to difficult ground conditions, changing site requirements and severe winter weather.

Delivering the Core Infrastructure

Kantey & Templer’s civil engineering scope included:

  • approximately 3.5 km of water reticulation
  • approximately 3.7 km of sewer reticulation
  • approximately 3.4 km of internal gravel roads
  • stormwater infrastructure included in the original project scope
  • design and construction supervision of the internal civil engineering works

The project required close coordination between the client, contractor, municipality and professional team throughout construction.

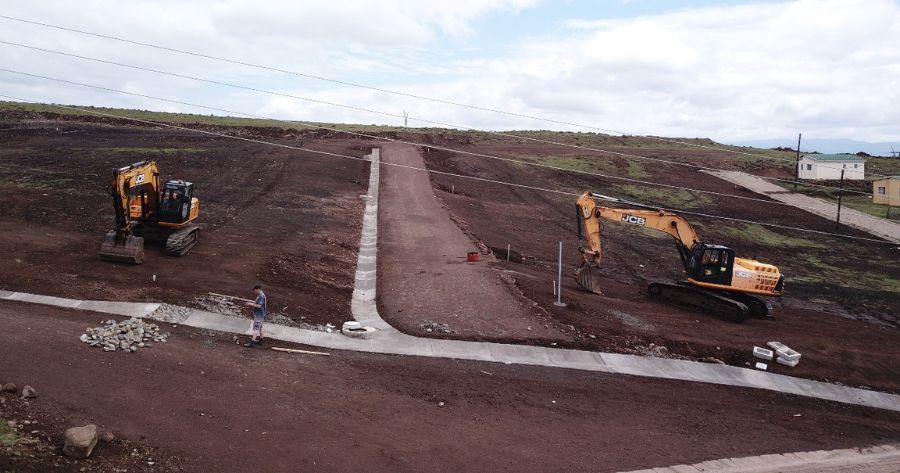

Civil engineering earthworks underway at the Barkly East infrastructure project

Responding to Unforeseen Ground Conditions

One of the most significant challenges encountered during construction was extensive hard rock during trench excavation.

These conditions affected both the methodology and rate at which portions of the underground services could be installed. The project team assessed alternative construction methods, including controlled blasting, while maintaining appropriate technical and safety controls.

Further unforeseen works included the rerouting of a borehole pipeline and the demolition of an existing underground shooting range.

Road construction also required additional intervention when poor subgrade conditions were encountered. A 300 mm pioneer layer was introduced where required to improve formation stability.

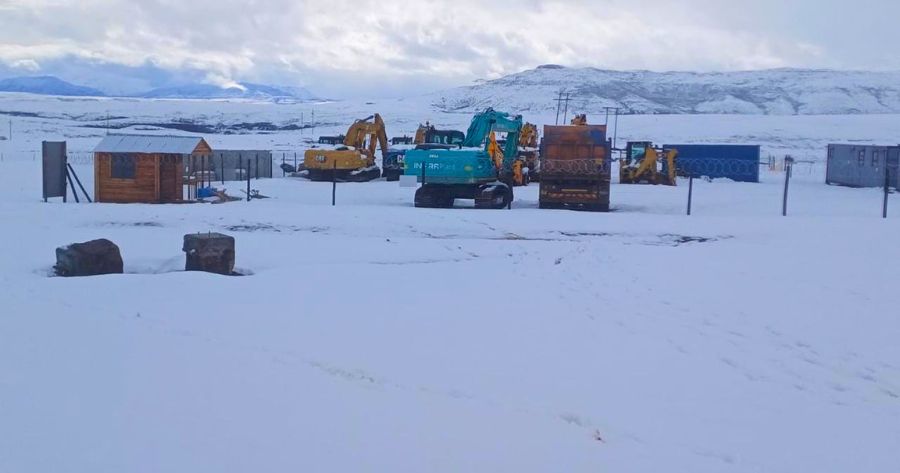

Snow-covered Barkly East construction site during severe winter weather

Working Through Severe Weather

Ground conditions were not the only challenge.

Heavy snowfall during June and July 2025 created additional pressure on the construction programme and site activities.

Together with unforeseen ground conditions and additional works, these challenges contributed to the construction programme extending from the original six months to a total of 12 months.

Throughout this period, the project team maintained structured monitoring of the programme, technical queries, site instructions, quantities and contractual variations to manage the impact of changing conditions.

Managing Change

Formal change control became an important part of the project.

Additional works were assessed through the contractual variation process, while RFIs, site instructions and action items were tracked to make sure technical decisions were implemented.

Regular technical and progress meetings were used to resolve design queries and interface issues, while quantities and contractor submissions were verified as part of ongoing cost and quality control.

This structured approach helped maintain visibility over programme, cost, quality and risk as conditions changed.

The original contract value was approximately R15.63 million, with the final contract value reaching approximately R17.97 million. The project highlights the importance of structured cost management and contractual oversight when unforeseen conditions and changes arise during construction.

Infrastructure with a Direct Community Impact

The significance of the Barkly East project extends beyond the technical works themselves.

The project serviced 303 residential stands, providing essential civil infrastructure to support residential development in Barkly East. The works included water and sewer reticulation, internal roads and stormwater infrastructure within the original project scope.

The project also demonstrates the importance of responsive engineering and project management when actual construction conditions differ substantially from initial assumptions.

For Kantey & Templer, Barkly East is an example of how technical judgement, construction monitoring, contract administration and stakeholder coordination work together to keep complex infrastructure projects moving forward.

Project at a Glance

Project: Barkly East 298 – Installation of Internal Civil Engineering Services
Location: Barkly East Township, Eastern Cape
Sector: Urban Development
K&T Role: Design and Construction Supervision
Status: Complete
Residential Stands Serviced: 303
Infrastructure: Water reticulation, sewer reticulation, internal roads and stormwater (original scope)
Original Programme: 6 months
Actual Programme: 12 months
